Septic in Saranac Lake, NY

Last updated: Apr 26, 2026

Where Septic Systems Are Common in Saranac Lake

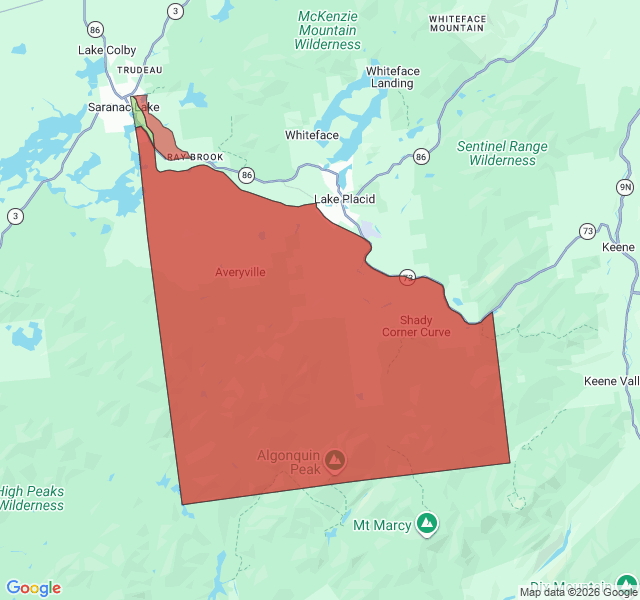

Map of septic coverage in Saranac Lake, NY

Adirondack Soils and Spring Thaw Limits

Local soil character and bedrock reality

In this area, the ground hides limits that bite into septic performance. Saranac Lake sits in the Adirondack region where glacially derived soils commonly include acidic Spodosols and dense till. Those soils drain slowly under normal conditions, and the acidity can hinder some natural attenuation processes. Bedrock near the surface further constrains usable vertical space for any conventional absorption area. With only limited depth to place a drain field before you hit solid rock, every inch of usable soil becomes critical. The combination of glacial till and shallow bedrock creates a highest-risk scenario for standard designs, especially when the system must function through the shoulder seasons.

Snowmelt and seasonal water in a tight frame

Seasonal snowmelt and spring rains are not distant events here; they arrive as a pulse that can raise the water table quickly. When the spring thaw saturates already moderately well to poorly drained soils, the efficiency and reliability of absorption areas drop fast. Water-filled soils push the drain field into saturation longer than typical soils, increasing the risk of effluent resurfacing at the surface or backing up into the home before the system has a chance to operate. In practical terms, this means a larger portion of the year may stress the same septic design that would otherwise suffice in drier locales. It also magnifies the importance of selecting a design capable of tolerating transient saturation without compromising soil structure or creating surface ponding.

Design limits you must respect

Because bedrock limits vertical separation and the soils' natural drainage behavior, conventional absorption areas often cannot be placed where they previously would have worked. Shallow till and acid soils challenge the soil‑water–root interactions that remove or attenuate effluent. When spring is in full swing and the ground holds water, gravity forces throughout the soil column slow dramatically, and the system's treatment stage becomes the bottleneck. The result is a higher risk of system distress if the chosen design relies on typical single-stage drainage. Any plan must anticipate periods of perched water and restricted soil permeability, not just average conditions.

Practical actions you can take now

Start with a conservative evaluation of site conditions during the wettest weeks of spring. If the site shows perched water or near-surface saturation for extended periods, consider the need for extended drainage pathways or alternative designs that maintain separation even when the soil is damp. You should verify the depth to bedrock at multiple points around the proposed absorption area, not just in one corner of the yard. In addition, plan for temporary storage or alternative load management during peak infiltration windows to avoid pushing effluent into marginal soils. Because acidic Spodosols resist rapid filtration, protecting the drain field from ongoing chemical stress is essential; use noncorrosive materials and avoid excavations that destabilize the soil structure during wet seasons.

Monitoring and early warning

Install a straightforward monitoring routine for early signs of saturation or surface dampness near the drain field. Periodically observe outlet and infiltration indicators after thaw events and heavy rain. If effluent odors or damp patches appear, treat them as urgent indicators to reassess the design and spacing, and consult a qualified septic professional promptly. In this climate, proactive design choices paired with vigilant seasonal monitoring are not optional extras-they are the core defense against system failure in a coastal-to-mountain Adirondack context.

Why Mounds and LPP Are Common in Saranac Lake

Soil and seasonal constraints

Because dense till and shallow bedrock can limit trench depth and infiltration, mound and low pressure pipe systems are often more workable than standard trenches on difficult lots. The combination of Adirondack glacial till and shallow bedrock means that soil just beneath the surface may not accept effluent quickly, especially after rapid spring snowmelt. In practice, this pushes designers toward drain fields that place effluent higher off the ground or distribute it through a more controlled, pressurized path. The result is a system that can tolerate slower percolation without overburdening the surrounding soil during peak melt periods.

Design implications for the site

Spring thaw saturation tends to saturate soils near the surface in ways that constrain infiltration for extended periods. Mound systems address this by elevating the drain field above the native water table, creating a more predictable zone for the effluent to exit and disperse. Low pressure pipe (LPP) systems, with their pressurized distribution and smaller trench footprint, can negotiate tight spaces and limited soil depth while maintaining a level of infiltration control that older conventional layouts may lack on the same site. On lots with shallow bedrock, these arrangements help avoid blasting or extensive soil replacement, while still meeting drainage goals.

When traditional options still fit

Gravity and conventional systems are still used locally, but conservative drain field sizing is often needed because of slow drainage conditions. On some parcels, a conventional layout remains the simplest or most economical choice if the soil above the rock and till provides enough capacity, or if the seasonal groundwater rise is manageable within standard trenches. In those cases, careful evaluation of percolation tests and seasonal groundwater behavior guides the design to prevent early saturation or perched water in the trench.

Chamber systems and site practicality

Chamber systems may reduce excavation complexity on rocky sites, but they still depend on the same local soil and seasonal groundwater constraints. The shallow bedrock can limit trench length even for chamber installations, so the layout must account for the actual available space and the frost behavior typical to the area. When space is tight or rocky conditions complicate digging, chambers offer a practical alternative, provided the soil retains adequate drainage and the system is sized to handle the anticipated groundwater fluctuations with spring thaw in mind.

Practical considerations for the homeowner

If your lot has dense till or rocky overlays, discuss with your designer how the chosen system adapts to spring thaw dynamics and the inherent slow drainage. Expect that mound and LPP configurations will ethically balance performance with soil limitations, especially in years when meltwater arrives quickly. Ensure the plan includes contingency measures for saturated conditions and a clear strategy for ongoing assessment of drainage performance during seasonal transitions.

Failure Patterns on Rocky Wet Lots

Spring thaw saturation and absorption slowdown

The most locally relevant performance risk is trench or field saturation during spring thaw, when absorption slows and backups or surfacing effluent become more likely. In Saranac Lake's rocky, glacially influenced soils, the combination of rapid snowmelt and shallow bedrock means the drain field can reach its limit quickly as moisture pushes into the near-surface layer. When soils are already holding water from the last freeze, a system operating near capacity may exhibit slow draining, gurgling fixtures, or mild surface dampness near the drain area. The consequence is not only wastewater backup indoors but also increased risk of effluent pooling in low spots or along the crest of mounded installations. Planning that accounts for a winter-to-spring moisture transition helps reduce the chance of an abrupt failure when spring temperatures finally rise.

Poorly drained glacial soils and seasonal moisture swings

Poorly drained glacial soils and seasonal moisture swings can shorten the margin for error if a system is undersized or overloaded. The combination of shallow bedrock and glacial till can leave limited vertical space for effluent to percolate, meaning even normal household loads may push the system toward infiltration limits during wet periods. In practice, a small rise in seasonal groundwater or a late thaw can translate into longer pump-down cycles, slower filtration, and a heightened probability of effluent surfacing at the surface or migrating toward side slopes and shallow drainage paths. The result is not merely a nuisance; prolonged saturation increases the risk of root intrusion, odor migration, and accelerated deterioration of field components. Homeowners should recognize that the margin for error is small once soils stay consistently moist.

Frozen winter ground and repair access delays

Frozen winter ground can delay repairs and pumping access, turning a marginal fall or spring problem into a longer outage. Access during cold months is often constrained by ice, frozen soils, and limited equipment maneuverability, which means a minor issue that could be addressed in a window of a few days in milder seasons may linger for weeks. When thaw cycles resume, the backlog compounds: parts waiting for repair, a full or near-full tank, and saturated trenches that take longer to regain proper drain capacity. The practical effect is a season-long vulnerability where operational slack is eroded, and household wastewater management becomes more fragile. Proactive seasonal maintenance-catch basins, riser access, and clear pathways to the mound or trenches-helps keep winter-to-spring transitions from becoming extended outages.

Saranac Lake Installation Cost Drivers

Local soil and excavation complexity

In Saranac Lake, glacial till, shallow bedrock, and frequent spring thaw drive up excavation difficulty and can push design toward mound or low pressure pipe systems. Typical local installation ranges are $15,000-$28,000 for conventional, $16,000-$30,000 for gravity, $25,000-$60,000 for mound, $20,000-$45,000 for LPP, and $12,000-$25,000 for chamber systems. When rock or dense till slows trenching or requires deeper excavation, costs climb quickly. Contractors factor additional rock removal, longer equipment runs, and more complex site restoration into the price.

Site constraints that influence design

Costs rise on lots where glacial till, rock, or shallow bedrock force more excavation or push the design toward mound or LPP systems. A shallow groundwater table or rapid spring saturation can limit where a drain field can be placed and may necessitate waste-water distribution approaches that accommodate wetter soils. Expect steeper bids where the soil profile offers less vertical drainage or where the leach field must be elevated, compacted, or segmented to avoid perched water pockets.

Seasonal timing and scheduling pressure

Cold-weather constraints, frozen ground, and spring saturation can compress the workable construction season and create scheduling pressure that affects pricing. Short windows for trenching and backfilling mean crews may charge a premium for rapid mobilization, extended work days, or layered work sequences (grading, backfilling, and soil replacement) to finish before frost returns. Planning ahead for shoulder-season availability can help stabilize both timing and cost.

System choice and cost implications

Here are typical local ranges by system type to guide budgeting decisions:

  • Conventional: $15,000-$28,000
  • Gravity: $16,000-$30,000
  • Mound: $25,000-$60,000
  • Low pressure pipe (LPP): $20,000-$45,000
  • Chamber: $12,000-$25,000

If soil limitations mandate a mound or LPP, expect a material premium and longer installation duration. For less challenging sites, a chamber or conventional gravity layout may offer the most economical path, though site-specific constraints still apply. Preparing for potential rock removal, extended trenching, and staged work can help set realistic expectations for both price and schedule.

Best reviewed septic service providers in Saranac Lake

  • Dawson's Tri-Lakes Septic Service

    Dawson's Tri-Lakes Septic Service

    (518) 891-3266 dawsonstrilakesseptic.com

    Serving Franklin County

    5.0 from 5 reviews

    Dawson's Tri-Lakes Septic Service has served the Lake Placid, Saranac Lake, Tupper Lake, and surrounding areas since 1997. We specialize in septic tank and sewer services for homeowners and businesses.

Franklin County Permits and Final Approval

Governing authority and pre-installation requirements

In this county, septic permits are issued and overseen by the Franklin County Department of Public Health. Before any septic system is installed, a soils or perc evaluation must be conducted, and the proposed system design must receive formal approval. The unique local conditions in this area-shallow glacial soils, bedrock proximity, and the rapid transition from spring thaw to saturated soils-mean that the evaluation is not simply a bureaucratic step but a practical check that the planned design will function under Saranac Lake's climate and soil realities. Having the evaluation and design approved early helps prevent later redesigns tied to groundwater or drainage limitations that can arise after thaw events.

Evaluation focus and design approval

The soils or perc evaluation assesses drainage capacity, percolation rates, and the feasibility of the recommended system type for the site. In Saranac Lake, where soils can be slow to drain and bedrock may limit excavation, the evaluation informs whether a conventional, gravity, mound, low-pressure, or chamber system is appropriate. The county's approval process expects accurate, site-specific information about thaw cycles, seasonal groundwater fluctuations, and snowmelt impact. Ensuring the proposed design aligns with these conditions reduces the risk of field failures during high-water periods and supports a more reliable long-term performance.

Construction-phase inspection and final compliance

Installation is inspected as work progresses to verify compliance with the approved design, applicable codes, and site conditions. This ongoing oversight helps catch deviations that could compromise performance in spring thaw periods or in shallow soils. Upon completion, a final inspection is required to confirm that the system has been installed as approved and that all components are properly integrated with the building plumbing and drainage plan. The final step in compliance is submission of an as-built drawing, which documents the actual locations of the septic tank, drain field, and any mains or risers. This record supports future maintenance and during any site reviews. Notably, the county does not require an inspection at sale based on current local data, but maintaining the as-built drawing is essential for future reference and potential reporting needs.

Practical tips for homeowners and contractors

Coordinate early with the county health department to schedule the soils or perc evaluation well ahead of project start, especially given how spring thaw conditions can influence soil behavior. Ensure the design drawings clearly reflect the approved plan, including depth to bedrock, seasonal high-water considerations, and any mound or alternative drain field features proposed for saturated soils. Keep the as-built drawing in a accessible place with other property records, and update it if any later modifications occur. This documentation supports ongoing maintenance and helps with smooth transitions during property changes or inspections.

Maintenance Timing for Adirondack Conditions

Baseline service interval

In this region, a three-year pumping interval serves as the local baseline. For properties with mound or low-pressure pipe (LPP) systems, and for soils that drain slowly due to shallow glacial till or partial bedrock, expect service closer to that three-year mark rather than slipping to longer cycles. If a system sits on slower soils or has a design that already struggles with rapid saturation, scheduling more frequent pumping helps keep the drain field healthy year-round and avoids longer dry spells that can compromise filtration.

Seasonal access and field stress

Spring thaw and midwinter freeze put extra stress on field access and on the drain field itself. Moist soils during thaw push near-saturation conditions, making excavation, access, and pump-out work more challenging. In contrast, late spring and early fall typically yield drier, more stable soils that are easier to reach without compacting the soil around the field. Plan maintenance during those windows to minimize soil disturbance and to promote more reliable service without weather-related delays.

Field design and soil considerations

Adirondack soils in this area tend to rush toward deficiency in drain capacity when saturated, especially with shallow bedrock. For homes with mound or LPP designs, or for properties where the soil drains slowly, timing becomes a practical tool: align pumping with drier periods to reduce field stress and improve effluent infiltration. If a previous service history shows rapid saturation after snowmelt or heavy spring rain, consider scheduling pumping just before the dry-season window to reset field pressure and extend the next interval.

Practical planning steps

Mark a tentative pumping plan on a three-year cycle, but flag adjustments when wet seasons arrive or when field access issues arise. If a late-spring or early-fall window is forecast, shift maintenance to that period when the soil is most cooperative. Communicate any soil moisture concerns or field access limitations to the technician so the pump-out can be performed efficiently and with minimal disruption to the drain field.
